Plugging wells

Chapter 5: Cessation

The Norwegian continental shelf (NCS) has a large and growing number of wells. Exploiting the big investment which a well represents for as long as commercially justified is important. The companies must accordingly assess reusing existing wells to maintain profitable production on a Field.

Calls have been made over the past three-four years for spare rig capacity to be used for plugging all idle wells. The NPD believes this would represent poor resource management. See the article of 23 November 2015 on plugging of wells can prevent value creation.

The NPD understands why questions are raised about why many apparently idle wells are not plugged. All wells shall be permanently plugged and abandoned (P&A*) in an acceptable manner. It is therefore important that the industry continues to identify new technology and solutions which can help to reduce the time and cost of P&A.

* P&A refers in the case of exploration wells to straightforward permanent P&A. Where production/injection wells are concerned, it involves ceasing to produce/inject and then permanently plugged.



Well statistics

All well paths have a fixed starting point known as the wellhead. This can stand on a production platform or in a subsea template, and defines the top of the well. Several well paths can be drilled from each wellhead. So far, an average of two well paths have been drilled per wellhead on the NCS. “Well” is used here a collective term for all well paths leading back to a single wellhead.

The NPD’s well statistics show that more than 2 000 well paths are neither in use nor permanently P&A. This could encourage the view that an extensive P&A market now exists. However, the number of wellheads and the status for using them paints a different Picture

Three main reasons explain why several well paths are drilled from each wellhead

  1. An initial well path is drilled in some cases to determine exactly where the resources lie and thereby identify the optimum positioning of a well path in the reservoir. This first well path is then plugged, and a new one drilled for production use.
  2. Sidetracks. After a well path has been producing for a few years, the area it is draining could be fully depleted. Rather than drill a completely new well, the lowest section is plugged and a new path drilled out from the existing well to an area of the reservoir with remaining resources. This could be repeated several times in a well’s lifetime.
  3. Multilaterals. Two or more well paths are drilled in the same well to produce or inject simultaneously. In the event of problems with one lateral, it can be shut off while the others remain operational..

Well paths which have been shut in and plugged are designated inactive.

  • Shut in: production well closed for some length of time
  • Plugged: production well plugged while the field is still on stream
  • No plan: a production well which is shut in will be temporarily plugged, with permanent P&A when the facility has been removed
  • Unclarified: wells still being assessed for reuse or plugging.


Specific plans exist for reactivation of 145 shut-in wells on the NCS. The same applies to 45 of the plugged wells.

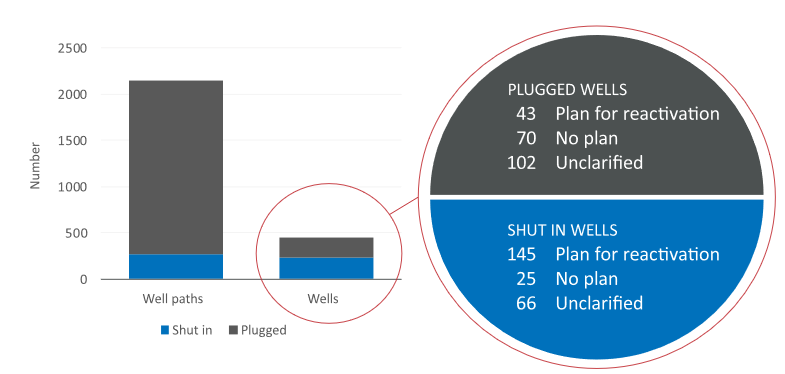

The bar chart above shows the number of inactive well paths and wells. A big difference exists between the number of plugged well paths and plugged wells. That reflects all the sidetracks. These wells will be permanently P&A when the field shuts down.

Status reports on well activities implemented and planned for fields on stream are obtained by the NPD on an annual basis. These cover such matters as why a well path is not in use and plans for the wells. The overview in the circle above shows that almost half the wells are covered by specific plans for reactivation, either through workovers or by drilling a new well path.

Some wells are also shut in because the production facilities lack capacity or to build up reservoir pressure. These can be reactivated when conditions change.

Gyda

Gyda is an oil field in the southern part of the Norwegian sector of the North Sea which came on stream in 1990. It has produced for eight years longer than expected in the plan for development and operation (PDO) and is now in its tail phase. Production is due to cease in September 2018. Before the Gyda platform can be removed and shipped to land for scrapping, 32 wells must be plugged and abandoned.


READ MORE: Before the lights go out on Gyda

Reducing well plugging costs

The final stage of P&A on Jotun is carried out by a modularised rig specially tailored for the field’s B platform. Coiled tubing has also been used to install downhole barriers in the wells. Cost reductions have been achieved by tailoring solutions, utilising simpler equipment with lower day rates, and reducing personnel requirements in the various phases of the work.
